Photovoltaic Pile Driver Exported to Australia for Large‑Scale Solar Farm Construction

crawler piling machine australia
crawler piling machine australia

This real‑world case study features a professional photovoltaic pile driver deployed in Australia. A local renewable EPC contractor undertook a large ground‑mount solar farm project. Complex mixed soil and strict construction deadlines severely limited traditional piling methods. After equipment comparison and site evaluation, the client chose YG Machinery piling solutions. This article displays real project background, field challenges, customized solutions, construction workflow, operational effects, and verified client feedback.

Key Takeaways

  • Proven Australian Field Performance: High-power crawler photovoltaic pile driver customized for Queensland’s hard-clay, sandy, and weathered rock soil conditions.
  • Significant Efficiency Boost: Achieves fast penetration, precise pile verticality, and zero machinery breakdown—significantly reducing rework and labor costs for utility-scale solar farms.
  • End-to-End Delivery & Compliance: Full-process support from factory pressure testing and certified biosecurity packaging to fast 55-day total fulfillment and local commissioning.

Get Factory Quote | WhatsApp/Tel: +86 183 3715 2861

Project Background for Australian Ground‑Mount Solar Farm Construction

Australia continues rapid expansion of utility‑scale solar farm infrastructure. This project is located in rural Queensland, a core area for Australian renewable energy development. The construction site covers a wide area with undulating terrain. The ground consists of mixed clay, sandy soil and scattered weathered rock.

Thousands of galvanized steel foundation piles needed uniform installation. Local Australian construction codes and grid connection rules require precise piling depth and verticality. Traditional manual tools and small rental machines failed to meet efficiency and quality standards. The client began searching for a reliable pile driver for solar projects to stabilize on‑site construction progress.

Professional tip: Most Australian rural solar sites contain mixed hard and soft soil. Always confirm geological conditions before selecting solar piling equipment.

Key Customer Pain Points Before Using Photovoltaic Pile Driver

The EPC contractor faced multiple technical and schedule barriers with old piling methods. Unstable equipment performance caused frequent delays and hidden quality risks. These problems increased labor costs and threatened project acceptance.

  • Mixed gravel and rock soil caused slow penetration and frequent tool jamming
  • Traditional piling produced inconsistent pile verticality across the site
  • Rental solar piling machines suffered high failure rates on hard ground
  • Low daily piling output could not match tight solar farm milestone schedules
  • Excessive manual intervention raised labor costs and safety management pressure

Local rental markets could not provide enough stable solar pile drivers for sale for large‑scale continuous construction. The client needed dedicated solar pile installation equipment optimized for Australia’s complex terrain.

Professional tip: Unqualified piling verticality will cause solar rack installation errors. Standardized hydraulic piling equipment effectively avoids rework.

Check Machine Price

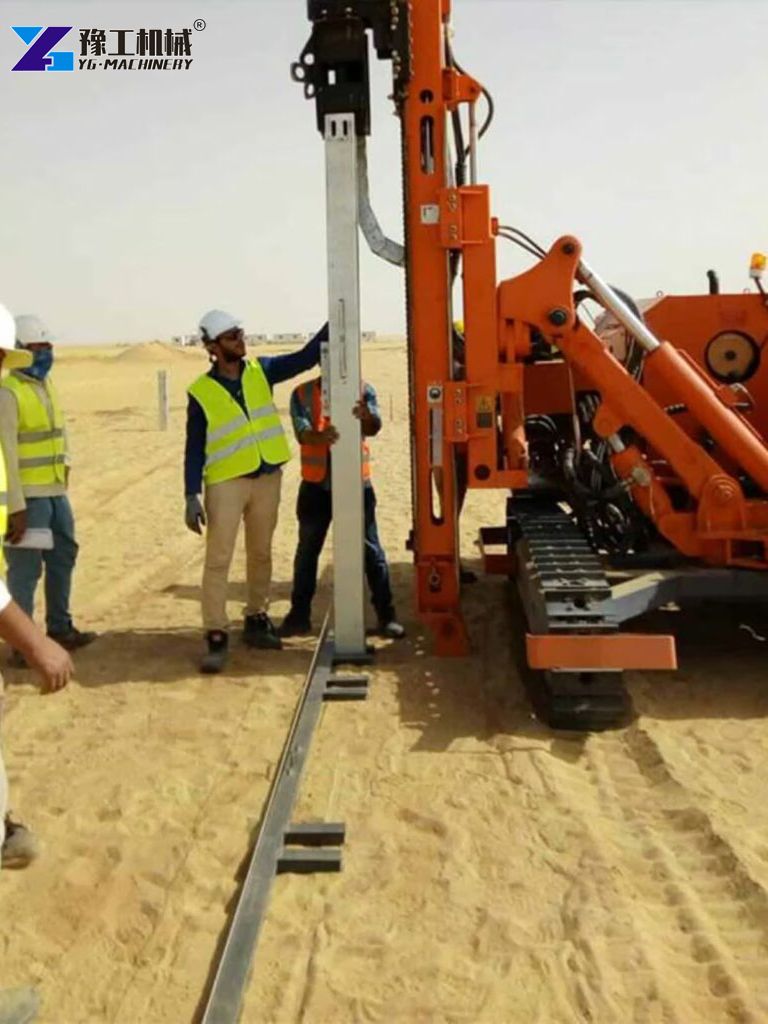

solar pile driver working site
solar pile driver working site

Custom Photovoltaic Pile Driver Solution for Australian Solar Farms

YG Machinery’s engineering team analyzed site geology, pile specifications, and construction intensity. We recommended the crawler photovoltaic pile driver for this Queensland solar project. This model adapts perfectly to undulating terrain and mixed hard soil conditions.

The machine is equipped with an 88kw high‑power engine and an optimized hydraulic hammer system. It supports adjustable impact frequency to protect thin‑wall steel piles. The flexible boom swing angle adapts to dense solar array layouts. The crawler traveling system ensures stable movement on slopes and uneven ground.

Professional tip: Adjust hydraulic impact frequency according to soil hardness. Lower frequency protects piles in soft soil; higher frequency accelerates penetration in rocky layers.

Photovoltaic Pile Driver Full Technical Parameters

ItemHydraulic photovoltaic pile driverCrawler photovoltaic pile driver
Overall dimensions4700*2100*2800mm4700*2200*2800mm
Track shoe width400mm400mm
Motor model41084108
Generator power88kw
Drilling diameter80‑500mm80‑600mm
Drilling depth0‑6m0‑6m
Reducer torque13000n.m
Mainstream pumptriple pump
Oil pump40/40/3240/40/32
Drill pipe rotational speed180r/min
Gradability30°30°
Rock hardness6‑20F
Slide tilt angle120°
Drill arm swing angleleft and right 150°left and right 150°
Slide swing angleleft and right 40°
Driving speed0‑3km/h3km/h
Hydraulic hammer flow50‑110L/min
Impact frequency350‑800BMP
Hydraulic system pressure25mpa
Strong wind for heat dissipationyes

Get Videos & Shipment Details

Pile Driver for Solar Projects: Production, Shipment and Commissioning

All photovoltaic pile driver and solar pile installation equipment passed strict factory testing before export. Each unit completed hydraulic pressure testing, hammer impact testing, and continuous running inspection. Machines were packed in fumigated wooden cases to meet Australian biosecurity standards.

The equipment was shipped from China Qingdao Port to Brisbane Port. Our technical team provided remote one‑on‑one guidance. Local workers completed machine assembly, hydraulic connection, pressure debugging and safety testing. Operators received professional training before official construction.

Full Project Timeline

Project PhaseDuration
Technical confirmation & order arrangement4 working days
Equipment production & factory inspection7 working days
Ocean freight to Australia Brisbane Port24 days
Customs clearance & site delivery5 working days
Installation, commissioning & operator training1 working day

Professional tip: Australian customs strictly checks wooden packaging. Use formal fumigation certification to avoid clearance delays.

solar steel pile installation
solar pile driver for sale
solar pile driver manufacturer
solar pile driver manufacturer-YG Machinery

Request Brochure or Catalog

On‑Site Construction Workflow and Practical Operation Effects

After commissioning, the photovoltaic pile driver started formal foundation construction. The team adopted standardized piling procedures to ensure uniform foundation quality for solar farm projects.

  • Mark precise pile positions according to solar farm survey data
  • Drive crawler machine into position and level the chassis
  • Adjust boom angle to ensure vertical piling tolerance
  • Start hydraulic hammer and complete graded penetration
  • Check depth and verticality after each pile installation
  • Move equipment forward for continuous batch piling work

After weeks of continuous operation, the photovoltaic pile driver showed excellent stability on complex soil. Daily piling volume increased significantly compared with traditional methods. Pile verticality fully met Australian solar engineering standards. No equipment failures or safety incidents occurred during the whole construction period.

Professional tip: Use staged piling on hard soil layers. Avoid long‑time high‑frequency impact to extend hydraulic system service life.

Verified Customer Feedback and Project Core Achievements

The Australian EPC contractor provided authentic on‑site feedback after long‑term practical use. The photovoltaic pile driver solved their most critical construction bottlenecks.

Thomas Bennett, Construction Manager, Australian Renewable EPC: “We used multiple rental pile drivers for solar projects before. Most machines struggled with our gravel-and-rock mixed ground. YG’s crawler photovoltaic pile driver runs stably all day long. Piling accuracy is consistent, and we have greatly reduced rework. This equipment helped us finish the solar foundation project ahead of schedule.”

The stable performance of this photovoltaic pile driver reduced downtime and labor dependence. It helped the contractor avoid schedule penalties and improve overall project profitability. The reliable equipment performance also enhanced their market reputation in local renewable bidding projects.

Request Solution for My Business

Key Project Achievements

  • Stable piling output adapted to Australian mixed soil and rocky terrain
  • Greatly improved daily construction efficiency and shortened project cycle
  • Guaranteed precise pile verticality and depth for solar foundation standards
  • Reduced manual labor input and lowered overall construction costs
  • Zero safety accidents and equipment failures during foundation construction
machine export shipping package
solar pile export shipping package
completed solar pile project
solar pile global customers

Industry Standard & Australian Solar Construction Compliance Guide

Australian solar construction follows strict local civil and renewable industry compliance standards. Ground foundation piling must meet uniform depth, verticality and load‑bearing requirements. Non‑standard piling work will delay grid approval and final project handover.

Most regional Australian solar sites feature unstable mixed soil and sloped terrain. Ordinary small piling machines fail to maintain consistent precision under these harsh conditions. Professional solar pile installation equipment solves compliance risks by delivering stable, repeatable piling results every shift.

Modern Australian EPC firms prioritize machine stability, low failure rates, and full after‑sales support. A reliable photovoltaic pile driver directly reduces project compliance risks, avoids construction rework, and ensures long‑term solar rack structural safety. Choosing a purpose‑built solar pile driver for sale helps contractors meet local renewable construction standards effortlessly.

Check Machine Price

Get Custom Photovoltaic Pile Driver Solution for Your Solar Project

If you are planning ground‑mount solar farm construction in Australia or other regions, contact YG Machinery for professional solutions. Share your site geology, pile size, and construction requirements. Our engineering team will provide optimized photovoltaic pile driver selection and a free quotation within 8 hours.

Email: admin@yugongheavy.com | Tel / WhatsApp: +86 183 3715 2861

photovoltaic pile driver CE certified
photovoltaic pile driver CE certified

    Please feel free to give your inquiry in the form below. We will reply in 24 hours.

    Product Model:

    Your Name(required):

    Your Email(required):

    Your Phone(required):

    Your country:

    Your Whatsapp(required):

    Your Message(required):

    Leave a Comment

    Your email address will not be published. Required fields are marked *
